The irrigation and landscape are 95% complete. We have completed the paint, acoustical ceiling tile, ceramic tile, and sisal wall coverings. The millwork, doors, and cabinets are being installed. The wood floor has started and will be finished in approximately 2 weeks. The mechanical, electrical, and plumbing contractors are working on trim and finishes. Carpet has tentatively been scheduled for June 4.
Tuesday, May 15, 2012
Monday, April 2, 2012
WEEKS 32 to 34 - 03/11/12 - 03/ 31/12
The masonry work around the exterior of the building has been completed with the exception of the screen walls for the mechanical pads. The footings for these walls have been formed and poured and masonry work will begin once the weather permits for exterior work. We have had some delays due to the continual rains that have come through the Houston area. But work continues to progress inside as the taping and bedding of drywall continues, the framing of the rostrum nears completion and the HVAC crews continue to work in the mezzanine areas.
Masonry
Masonry
Saturday, March 17, 2012
WEEKS 29 to 31 - 02/19/12 - 03/10/12

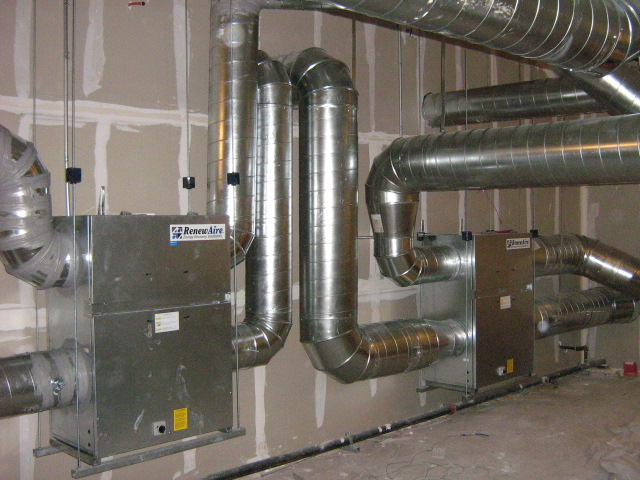

Brick has been installed to the exterior walls of the building and continues to progress. The parking lot lights have arrived on site. The installation of gypsum board has begun as walls and ceiling surfaces were covered and prepared for texture and paint. Acoustical ceiling grid was also installed while HVAC ducts were run up in the mezzanine area of the building.
Masonry
Masonry
Monday, February 13, 2012
WEEKS 25 to 28 - 01/22/12 - 02/18/12
The highly anticipated arrival of the steeple took place during the past few weeks. It was raised and installed with the use of a crane while the process of installing storefront doors and windows began at the main entrances and chapel areas. The interior of the building received the installation of gypsum board on the ceilings and corridor walls. Drywall tape and joint compound has been applied to many of the walls and ceiling surfaces and continues to progress throughout the building. HVAC ducts were installed in the mezzanine ceiling areas while electricians continued to rough-in interior walls.
Steeple
Steeple
